SBA updated its environmental review procedures under SOP 50 10 8, effective June 1, 2025, and the rules apply differently depending on loan program, property type, and use history. This article is written for SBA borrowers, lenders, CDCs, brokers, sellers, and landowners who need a clear picture of how that review actually works.
We'll walk through the path SBA lenders follow: initial information gathering, transaction screening, when a Phase I Environmental Site Assessment gets triggered, when a Phase II becomes necessary, and how identified concerns get resolved before closing.
Key Takeaways
- Start SBA environmental review early—before the loan application or purchase agreement is final
- Use property history, adjoining parcels, and industry class to set the required review level
- A recognized environmental condition means more evaluation, not contamination or automatic denial
- Verify current SBA forms, validity windows, and lender rules before ordering any assessment
SBA Environmental Due Diligence Requirements
SBA environmental due diligence is a documented investigation of real estate tied to an SBA-backed loan. It's designed to spot environmental risk before the SBA, the lender, and the borrower are financially exposed. It also protects the value of whatever's pledged as collateral.
Where Environmental Review Applies
Environmental review can come up any time real estate secures an SBA loan, including:
- 7(a) loans used to purchase, refinance, or improve commercial property
- 504 loans for purchase, construction, renovation, or qualifying refinance of owner-occupied real estate
- Acquisition and construction deals where the building itself becomes collateral
- Transactions where the property's history raises questions, even if loan proceeds aren't buying that specific parcel
Per SBA SOP 50 10 8, effective June 1, 2025, environmental review applies to commercial property offered as real estate security, and the required depth scales with contamination risk. Confirm scope details with your lender, since SOP editions change.
The Risk-Based Review Sequence

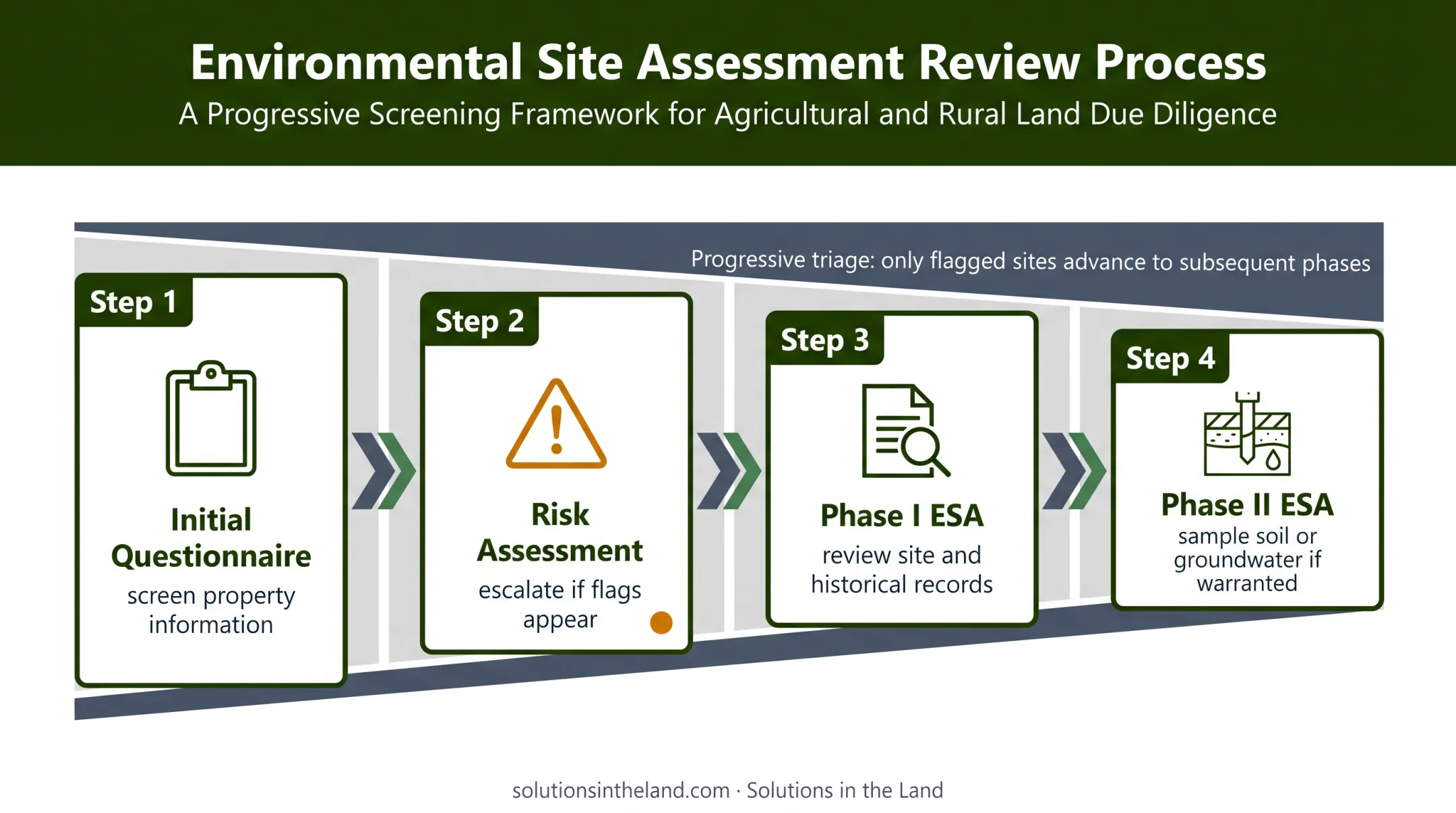

Review depth scales with what each step uncovers. The usual path is:
- Start with an Environmental Questionnaire or similar screening tool
- Escalate to a Records Search with Risk Assessment or Transaction Screen if flags appear
- Move to a Phase I ESA for site and historical records review
- Conduct a Phase II ESA with soil or groundwater sampling only if warranted

We break each step down in detail below.
What Property Owners Should Prepare
Borrowers and sellers speed up review by gathering this information before the lender asks for it:
- Current and historical property use, including prior tenants or operations
- Adjoining-property use and any known nearby contamination
- Hazardous-material storage, underground or aboveground tanks, and spill history
- Environmental permits, waste-handling records, and regulatory correspondence
- Prior environmental reports, even outdated ones
- Known liens or cleanup obligations tied to the property
Reliance Letters and Professional Qualifications
SBA and lenders generally require environmental professionals to issue reliance language allowing the lender and SBA to depend on the findings. Confirm the exact wording and submission process with your lender before the environmental professional starts work. A report missing proper reliance language can trigger a costly redo.
A compliance note: SBA forms, thresholds, and SOP editions change. Verify current requirements against the active SBA SOP, applicable ASTM standards, and your lender's or Certified Development Company (CDC) instructions rather than an older article or template.
How the SBA Review Process Works
SBA's review moves through five stages, though not every property goes through all five in full.
Step 1: Screen the Transaction Early
The lender, borrower, and environmental professional screen the deal early. They confirm:
- Intended use and collateral structure
- Loan program and industry classification
- Historical uses that could be red flags
This should happen right after the purchase agreement or loan request takes shape, not after underwriting locks in.
Step 2: Complete the Initial Questionnaire
Someone with direct knowledge of the property, usually the borrower or seller, completes and signs the environmental questionnaire. Adjoining-property information matters too.
Contamination doesn't respect property lines. A neighboring gas station or dry cleaner can trigger the same scrutiny as an issue on the subject site. Incomplete or inconsistent answers are among the most common causes of follow-up questions and delay.
Step 3: Escalate When Risk Appears
Certain property types move straight to a Phase I ESA regardless of loan size under current SBA SOP guidance. That includes current or known former uses matching SBA's list of environmentally sensitive industries.
Other properties can start with a questionnaire and initial risk assessment, escalating to a Phase I only if screening flags something other than low risk. Confirm the applicable pathway with your lender rather than assuming a generic sequence applies to every deal.
Step 4: Investigate Potential Contamination
A Phase I ESA relies on historical records, regulatory database searches, interviews, and a site walk-through. No sampling involved. A Phase II ESA goes further, using soil borings, groundwater monitoring wells, or vapor testing to confirm or rule out suspected contamination flagged in Phase I.
Step 5: Document the Resolution
The lender reviews report findings, reliance documentation, regulatory status, and any remediation or mitigation plan. Cost estimates and collateral-value impact factor in as well. Some findings require SBA review before the loan can close.
Who's Responsible for What
| Party | Primary Responsibility |
|---|---|
| Borrower | Supplies accurate property information and site access |
| Lender/CDC | Identifies the required SBA pathway, retains or submits documentation |
| Environmental professional | Performs an independent assessment following ASTM standards |
| Seller/owner | Provides historical and operational records |
An environmental concern surfacing mid-process doesn't automatically end a transaction. The outcome depends on the nature of the concern, applicable regulations, the lender's risk tolerance, and whether remediation or engineering controls can resolve it.
Recognized Environmental Conditions and Higher-Risk Properties

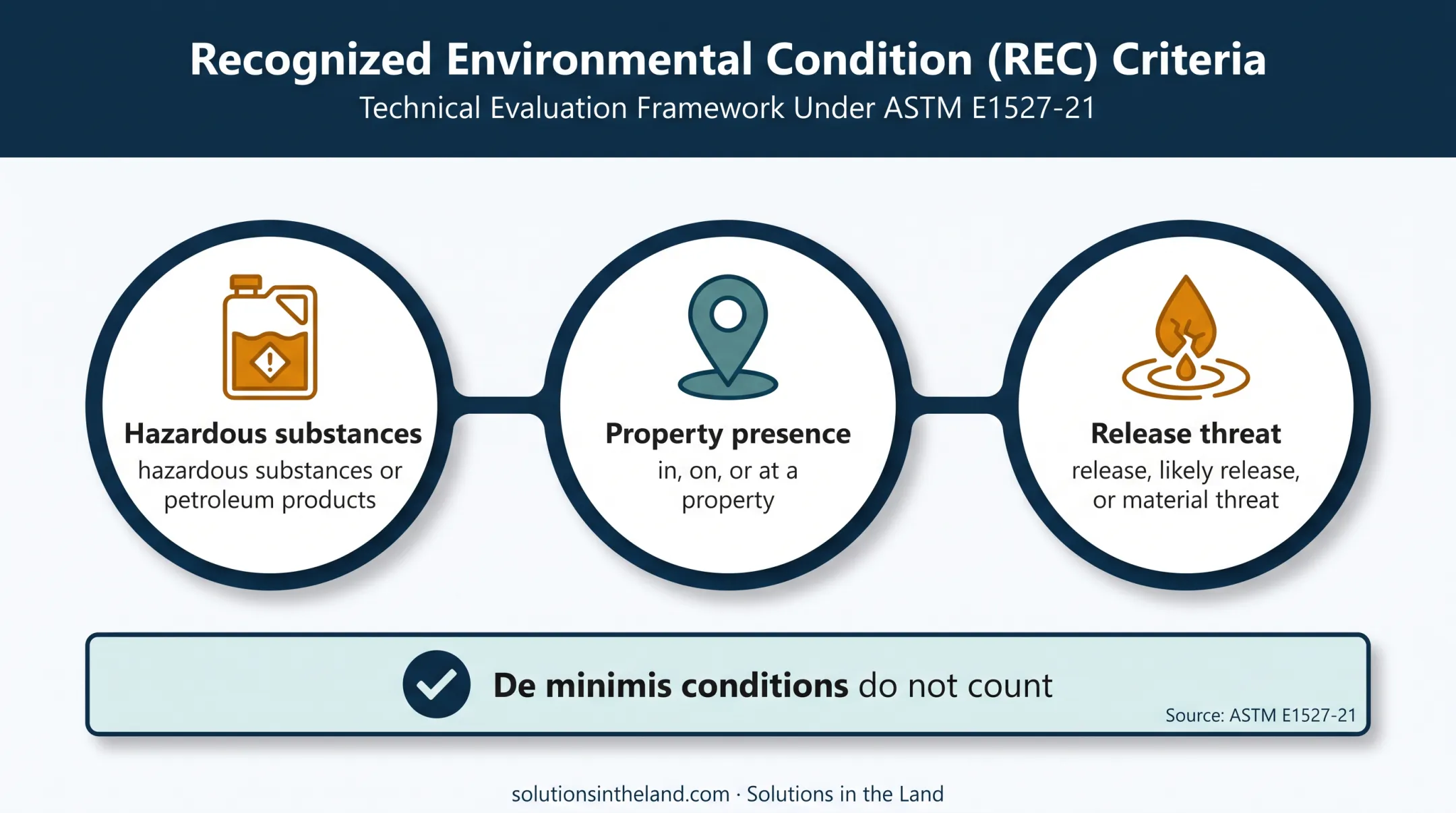

A recognized environmental condition (REC) has a specific technical meaning under ASTM E1527-21: the presence, or likely presence, of hazardous substances or petroleum products in, on, or at a property because of a release, likely release, or material threat of a future release. Minor, de minimis conditions don't count.

Examples That Environmental Professionals Look For
Common REC triggers include:
- Current or historical leaking underground or aboveground storage tanks
- Dry-cleaning operations using chlorinated or petroleum solvents
- Industrial or manufacturing history, including metal plating or circuit-board production
- Documented spills or waste disposal areas
- Contaminated soil or groundwater identified in agency files
- Regulatory records showing a prior release at or near the site
These are examples, not a self-diagnosis checklist. Only a qualified environmental professional can determine whether a specific condition meets the formal ASTM definition.
Why Farmland Deserves Site-Specific Review
Agricultural properties aren't automatically low-risk just because they're farmland. Factors that can prompt closer review include:
- Fuel storage or equipment maintenance areas
- Pesticide or fertilizer mixing sites
- On-site waste disposal or burn areas
- Former livestock or industrial uses on the parcel
- Contamination migrating from adjoining properties
None of this means every farm has a problem. It means farmland gets the same use-history scrutiny as any other collateral type, not a blanket exemption.
Properties That Draw Heightened Scrutiny
These property types typically require deeper review from the start:
- Gas stations
- Dry cleaners
- Manufacturing sites
- Waste-handling operations
- Child-occupied facilities built before 1978
- Properties with documented prior releases
Verify the current SBA list of environmentally sensitive industries with your lender, since these lists get updated.
What Follows an REC Finding
An REC triggers further work, which may include:
- Additional records research and agency file review
- Soil or groundwater sampling
- A Phase II ESA
- Regulatory consultation
- Remediation, engineering controls, or institutional controls
- Ongoing monitoring or a lender-approved risk-management plan
Loan Compliance vs. Long-Term Land Stewardship
SBA environmental due diligence answers one question: can this loan close given the property's environmental risk? It isn't designed to guide long-term land management decisions.
That's a separate conversation. Agricultural landowners thinking about broader farm planning, organic transition, or regenerative land management can work with Solutions in the Land on a whole-system farm plan that examines soil health, water resources, and long-term land use alongside the property's history. Those services complement SBA compliance work. They don't replace a required questionnaire, ESA, reliance letter, or regulatory remedy.
Timing and Common Deal Delays
Environmental review works best as an early conversation, not a last-minute scramble before closing. Start it during initial property and financing diligence, well before purchase agreements become irrevocable or underwriting locks in.
Report Validity Windows
SBA's technical update notice states that environmental investigation reports must be dated within one year of the SBA loan number's issuance. ASTM standards layer their own timing rules on top of that. Confirm current validity requirements with your lender before assuming an older report still qualifies.
Common Causes of Delay
- Incomplete questionnaires or missing signatures
- Undisclosed historical property uses
- Inaccessible areas during the site visit
- Outdated reports reused without verification
- Unclear or missing reliance language
- Late discovery of a recognized environmental condition (REC) after underwriting is nearly complete
- Unbudgeted remediation costs surfacing late
A Practical Preparation Checklist
- Ask the lender for current environmental requirements upfront so scope and timing are clear before underwriting advances
- Appoint one point of contact for the transaction
- Gather historical property records before they're requested
- Provide full site access to the environmental professional to avoid repeat visits
- Disclose known concerns early so findings don't surface after terms are set
- Budget for possible follow-up testing or remediation
- Get written confirmation before relying on any older report so validity is not assumed at closing
Cost planning belongs in that same early window—unbudgeted work is a common closing delay. Report fees, sampling costs, remediation, and monitoring are typically separate line items. Skip the generic price quote and get a property-specific estimate instead. Costs vary too much by region, property type, and scope to generalize.

Conclusion
SBA environmental due diligence is a structured risk-management process, not a final rubber stamp before closing. Bring the property's use history, adjoining-parcel information, and known concerns to the table early. That gives everyone time to set the right assessment level and fix issues before they threaten the closing date.
Practical next steps:
- Coordinate with your SBA lender or CDC and a qualified environmental professional as soon as a property is in play
- Confirm current SBA requirements rather than relying on last year's checklist
If you're a landowner thinking past loan compliance toward long-term land management, that work sits outside the SBA checklist. Solutions in the Land works with landowners on whole-system farm plans and regenerative transition strategies once the compliance work is settled.
Frequently Asked Questions
What is SBA environmental due diligence?
It's the documented investigation SBA lenders use to evaluate environmental risk tied to real estate offered as collateral. Exact requirements depend on current SBA Standard Operating Procedure (SOP) guidance and your lender's specific procedures.
What are some examples of recognized environmental conditions?
Examples include likely releases from leaking storage tanks, historical dry-cleaning or industrial operations, documented spills, and waste disposal areas identified in regulatory files. Only an environmental professional can confirm whether a condition meets the formal ASTM definition.
When is a Phase I Environmental Site Assessment required for an SBA loan?
Phase I requirements depend on the property's risk profile, current and historical use, loan structure, and current SBA procedures. Confirm the applicable pathway with your lender before ordering any report.
What happens if an environmental assessment finds contamination?
It typically leads to a Phase II investigation, regulatory coordination, and a review of remediation costs and collateral impact. Contamination doesn't automatically disqualify the loan; the lender and SBA weigh the extent of the issue against available solutions.
Who is responsible for ordering and paying for SBA environmental due diligence?
The lender or Certified Development Company (CDC) typically identifies which report is required, while the borrower usually covers the cost as part of the transaction. Check your specific loan agreement, since arrangements can vary by lender.
